CNC Milling Cost Guide: Factors, Hourly Rates & Price Reduction Tips

We break down CNC milling cost for engineers and buyers who need quote-ready clarity: CAPEX vs outsourcing, the five drivers that move price, and DFM choices that keep parts manufacturable without guessing an hourly rate.

A useful CNC milling cost estimate is not a single hourly number. It is a project-specific quote built from geometry, material, quantity, tolerances, finish, and the RFQ package you send the shop.

Understanding CNC Milling Costs: The “Quick Answer”

When teams ask about CNC milling cost, they usually mean one of two things: buying a machine (CAPEX) or paying a shop to make the part (OPEX). Mixing those models is the fastest way to misread a quote.

Buying a machine: CAPEX

Buying a CNC mill is CAPEX. Budget the machine plus tooling, workholding, CAM, inspection gear, maintenance, operators, floor space, and training—ownership cost is not the sticker price alone.

Outsourcing a part: OPEX

A supplier quote is OPEX for a specific job. It rolls material, programming, setup, machine time, inspection, finishing, and packaging into a part or batch price—compare quotes on the same RFQ scope, not on hourly rate alone.

As a broad planning reference, CNC machine-shop rates commonly fall between $50 and $200 or more per hour. The actual rate depends on machine complexity, capability, labor, inspection requirements, and the supplier’s operating model. A 3-axis mill and a complex 5-axis machining center should not be evaluated using the same hourly assumption.

Practical answer

There is no universal price for a CNC-machined part. Geometry, quantity, material, tolerances, surface requirements, and delivery expectations determine the quote. A simple aluminum bracket may be inexpensive per piece, while a low-volume multi-sided alloy component can require substantially more programming, setup, and inspection.

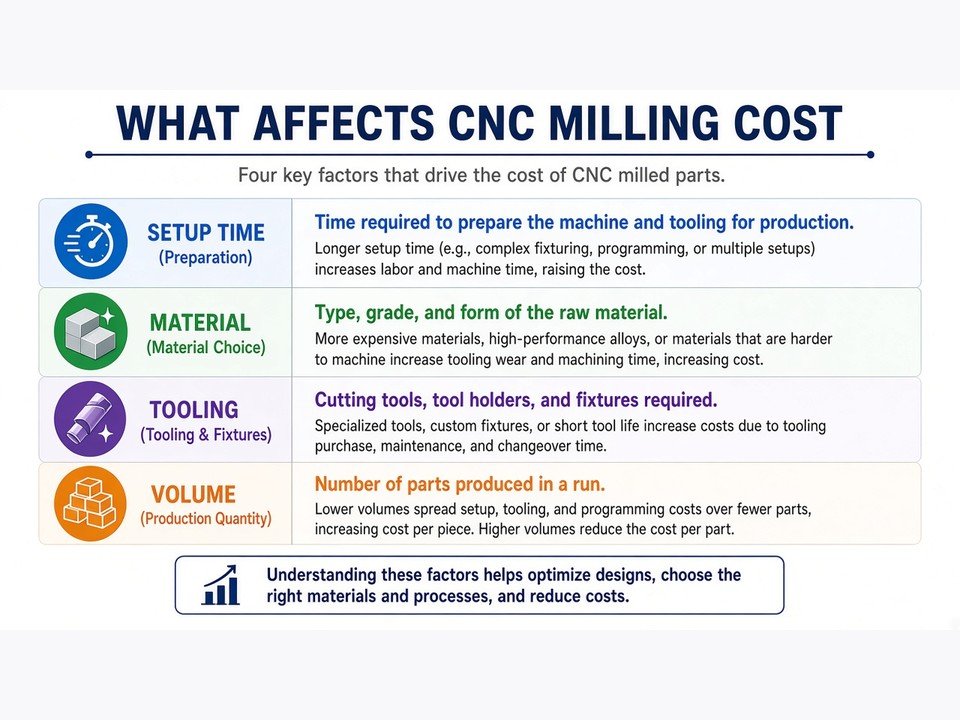

CNC milling machine cutting a precision metal component

The right cost discussion begins with the part and its manufacturing requirements, not with an hourly rate alone.

The 5 Key Drivers of CNC Milling Costs

At PartsMake, we price from the RFQ package: CAD/STEP, drawing, material grade, quantity, critical tolerances, finish, and application. Those fields map directly to the five cost drivers below—and to the design levers you can still change.

1

Material Selection

Material sets stock price and cut time. Call out the grade on the RFQ (for example 6061-T6 vs 7075-T6, or free-machining brass vs a tougher bronze). Soft, common stock cuts faster; hardened, exotic, or poorly machinable grades raise tool wear and cycle time. Design lever: switch to a more machinable grade when strength or conductivity still meet the print.

2

Machine Time & Complexity

Machine time covers cutting, tool changes, probing, and repositioning. Accessible 3-axis features usually cost less than undercuts, deep pockets, thin walls, or features that force a 4-/5-axis setup. For how axis count and platform choice affect capability, see our overview of machine-platform families. Design lever: keep critical faces reachable from fewer setups, and avoid geometry that only a multi-axis center can finish.

3

Setup & Programming

Programming, fixtures, tool lists, offsets, and first-article checks land as setup cost amortized over quantity. RFQ field: state prototype vs production qty clearly. Design lever: reuse standard stock sizes and fixturing-friendly datums so setups stay simple when volume grows.

4

Tolerances & Precision

Tight tolerances slow feeds, add finish passes, and drive inspection time. Mark only critical dimensions on the drawing; use a clear general tolerance class elsewhere. RFQ field: highlight fits, seals, and datums that must be held. Design lever: loosen non-functional dims before asking the shop to “hold everything tight.”

5

Post-Processing & Finishing

Deburring, anodize, powder coat, heat treat, or other finishes add handling and lead time. Specify only what the application needs (corrosion, wear, cosmetics, or sealing). RFQ field: finish callout plus any masking or Ra requirement. Design lever: accept as-machined where appearance is not critical.

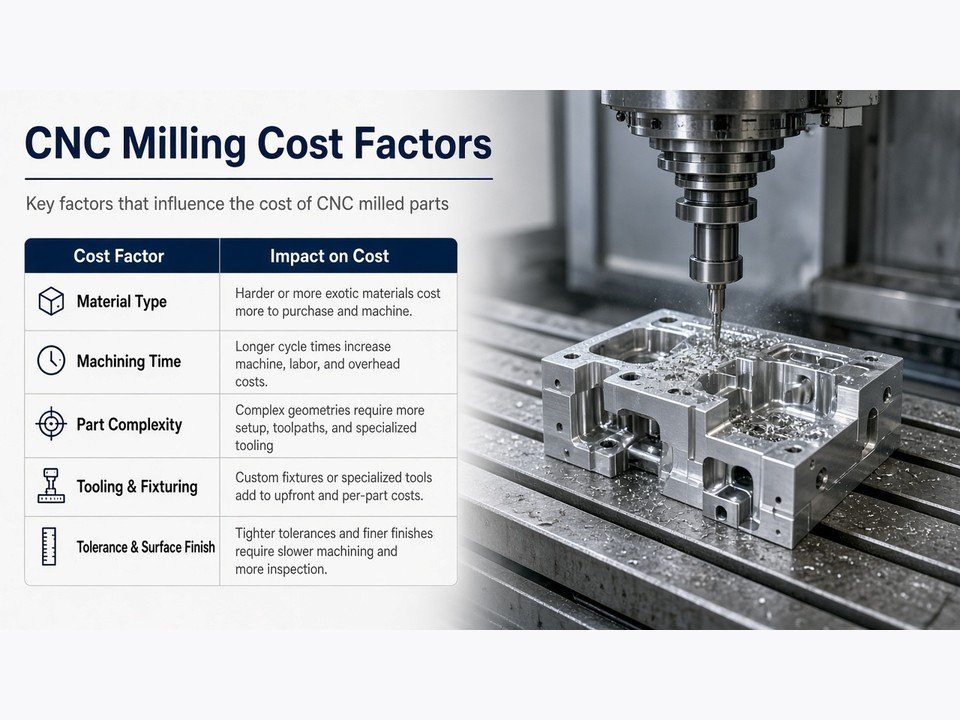

Finished CNC milled parts prepared for inspection and surface finishing

How to Calculate Your Project Costs

Treat early cost math as a quote-package checklist, not a substitute for a shop quote. Separate one-time setup from recurring per-part work using this planning formula:

(Setup Cost + (Material Cost + Machine Time) × Quantity) + Finishing = Total Price

Use it to stress-test your RFQ before you send it: CAD + drawing + material + qty + critical tolerances + finish should all describe the same part. Two similar shapes can still quote differently when those fields diverge.

01

Define the setup

List programming, fixtures, workholding, tool prep, and first-article verification as one-time line items on the RFQ.

02

Estimate recurring work

Estimate stock usage plus cutting, tool changes, handling, and inspection time per piece—then multiply by quantity.

03

Add required finishing

Add deburring, coating, heat treat, marking, packaging, and any secondary ops you will actually buy.

Where DFM helps

DFM cuts cost before metal is cut. We check feature access, standard cutter sizes, internal radii, and whether tolerances and finishes match real function—so the quote package does not over-specify the part. More process context is in our CNC machining process notes.

Batch volume creates economies of scale because programming and setup costs are distributed across more pieces. Larger orders can reduce unit cost, but the best quantity depends on demand, inventory risk, cash flow, and design stability. A pilot batch may be the right choice when a product is still being validated.

Strategies to Reduce Your CNC Machining Costs

Cost reduction works best when you change design levers—not when you only ask for a lower number. Start with these concrete DFM moves.

Simplify Geometry

Prefer standard drill/ream sizes, generous internal corner radii (match common end-mill diameters), and features reachable in fewer setups. Tiny radii, deep narrow pockets, and undercuts often force specialty tools, extra ops, or 5-axis workholding.

Standardize Materials

Default to widely stocked grades (for example 6061 aluminum or free-machining brass) when properties allow. Standardizing grades across a family of parts simplifies purchasing and often lowers both stock and cycle time.

Optimize Tolerances

Hold tight only on interfaces, bearings, seals, and datums. Put a general tolerance class on everything else—blanket ±0.01 mm across the print is an expensive habit.

Plan Volume Carefully

Stable design + predictable demand → larger batch to amortize setup. Still iterating → pilot qty so you do not buy scrap inventory when the CAD changes.

Use Instant Quoting Strategically

Instant or automated quotes are useful for early screening and spotting outlier cost drivers. For tight tolerances, special finishes, or multi-setup parts, keep an engineering review in the loop before you release the PO.

Design review checkpoint

Before the final quote, align CAD, drawing, material grade, quantity, critical dims, finish, and inspection notes so they describe one part—not conflicting versions.

Outsourcing vs. In-House: Making the Right Choice

The right choice depends on more than the apparent per-part price. We recommend comparing the complete manufacturing responsibility, including programming, maintenance, quality control, scheduling, and production risk.

Consideration In-house may fit when Outsourcing may fit when
Demand Long-term, repeat production can support equipment utilization. Prototypes, variable demand, or limited production do not justify ownership.
Part complexity The required process is already within your team’s capability. Complex multi-axis parts need specialized equipment or experience.
Business constraints Proprietary IP or immediate internal access is a priority. Shop space, staffing, maintenance, or capital are constrained.

Domestic and international manufacturing also require a complete comparison. A lower quoted piece price may be offset by shipping, customs coordination, longer lead times, communication overhead, or additional quality-control work. On the other hand, an experienced international partner can coordinate machining, finishing, inspection, packaging, and repeat production through one project team.

PartsMake supports engineers, product developers, startups, OEMs, and procurement teams from prototype through repeat production. Our manufacturing scope includes CNC milling, 5-axis machining, turning, mill-turn, Swiss machining, injection molding, sheet metal fabrication, 3D printing, finishing, and inspection, allowing us to assess the most appropriate process for the part rather than forcing every project into one method.

Frequently Asked Questions (FAQ)

How much does it cost to have something CNC machined?

Simple 3-axis aluminum parts often land at the low end; tight-tolerance or multi-setup jobs climb quickly. Shop rates of roughly $50–$200+/hr are only a planning band—your RFQ fields (material, geometry, qty, finish, inspection) decide the real price.

What does a CNC mill cost?

A hobbyist or desktop unit and an industrial machining center serve very different purposes, so their purchase prices and ownership costs are not directly comparable. The total investment should include tooling, workholding, software, installation, maintenance, operator capability, inspection, and available floor space—not only the machine purchase price.

How much does CNC cutting cost?

“CNC cutting” can mean different processes. CNC milling removes material with rotating tools and is suited to 3D features, pockets, holes, and contoured surfaces. Laser or waterjet cutting is typically used to cut profiles from sheet or plate. The better process depends on thickness, material, geometry, edge requirements, quantity, and secondary operations.

How can I get an accurate quote for my part?

Send clean CAD/STEP plus a drawing for any critical tolerances, finish, or inspection. State quantity, application, finish, and target lead time. Complete RFQs let us price risk—not guess it—and usually return a tighter, more comparable quote.

Conclusion: Optimizing Your Manufacturing Budget

The best time to manage CNC milling cost is before the design is released for production. Material selection, feature accessibility, tolerance strategy, batch planning, finishing, and inspection requirements all influence the final price. Early decisions are usually less expensive to change than production tooling, rework, or a delayed launch.

We encourage engineers and purchasing teams to involve a machinist during the design phase. A practical DFM review can reveal hidden cost drivers, clarify which dimensions are critical, and identify whether another process or production volume would better support the application.

At PartsMake, manufacturing starts with understanding the part—not simply starting the machine. Our team reviews CAD files, drawings, materials, tolerances, critical dimensions, surface requirements, quantities, and intended use before production begins. Upload your design for a custom quote, or contact us to discuss a DFM review and manufacturing plan.

Ready to evaluate your CNC milling cost?

Send us your CAD files and project requirements. We will help identify the major cost variables and determine a practical path from prototype to production.

Request a Custom Quote
